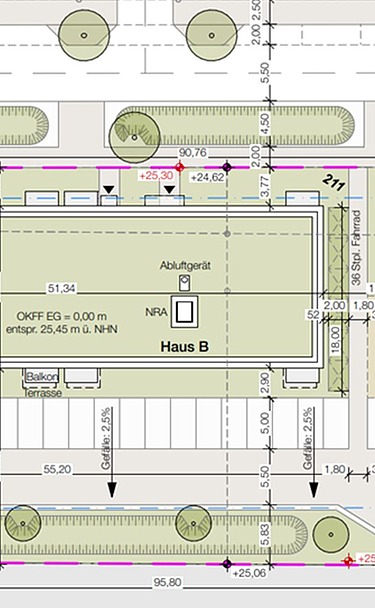

Construction plan multi-family houses
Construction plan multi-family houses © siebrechtmünzesheimerarchitekten gmbh

GWSH Neumünster

Location:
Neumünster

Completion:
2024

Back to Projects

GWSH Neumünster

Location Graveshamstraße 5-9 in Neumünster

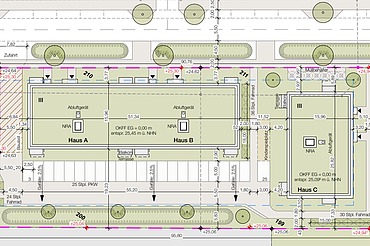

Three similar, three-storey apartment buildings with a total of 36 residential units, 25 ground-level car parking spaces and enclosures for a total of 60 bicycle parking spaces are being built.

The storey and roof ceilings are designed as a reinforced concrete structure, the rising components almost exclusively as sand-lime brickwork.

The project is aiming for DGNB "Sustainable Building Site" certification from the German Sustainable Building Council.

  • Characteristics
    • Plot area (GF): 3,620.59 m²
    • Built-up area (BF): 1,301.65 m²
    • Gross floor area (GFA): 11,929.92 m³
    • Gross floor area (GFA): 3,581.97 m²
    • Above ground: 3 storeys
  • Construction time
    • Shell construction work from October 2023 to April 2023
    • Building envelope from March 2023 to September 2023
    • Expansion from May 2023 to November 2024
    • Completion March 2024
  • Construction site regular operation
    • Monday to Friday 07:00 to 19:00
    • Saturday 07:00 to 15:00
    • There is generally no work on Sundays and public holidays.

Certified by the German Sustainable Building Council (DGNB)

Ed. Züblin AG is pursuing several goals with this project: A sustainable construction site organisation, the conservation of resources as well as the minimisation of emissions, responsibility for the health and well-being of the builders, the cultivation of good neighbourliness and, of course, high-quality construction. For this, Ed. Züblin AG was the first company to be recognised by the German Sustainable Building Council (DGNB).

Here you can find more information about the DGNB system for sustainable construction sites: https://www.dgnb.de/en/certification/buildings/construction-site

Selected measures in the project

  • Finished parts

    The use of prefabricated parts (filigree slabs) enables a shorter construction time to be achieved. The volume of waste is also reduced thanks to the prefabricated orders.

  • Saving resources and reducing emissions through LEAN Construction

    As part of the lean approach, a production plan with call-off dates (e.g. insulation) was created. Construction production planning is detailed on a weekly basis and adapted to actual production progress. Changes in the construction process are constantly taken into account and just-in-time deliveries can be better implemented. Repeat orders and new orders due to late changes to the plan are avoided.

  • Measures to prevent pollution from the construction site

    Only plane masonry blocks are used for the walls in the shell construction. These are precisely dimensioned and prefabricated, eliminating noise and dust emissions on site, as no adjustments or cutting work is required. This also reduces the amount of waste.

Certification contact person Katharina Schütt
Project contact Ingo Harder
Construction site address Graveshamstrasse 5-9
24537 Neumünster

Phone +49 40 20208-0
ZÜBLIN Subdivision North
Secretariat Unit Turnkey Construction Hamburg / Schleswig-Holstein
Download Press release
Link DGNB: Certification
