TP3 extension Mercedes Benz
Location:
Fürth
Completion:
2026
TP3 extension Mercedes Benz

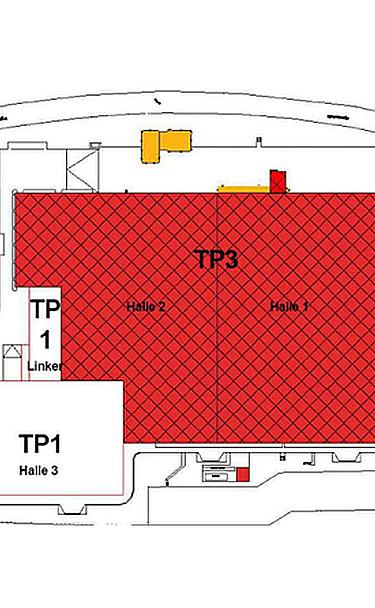

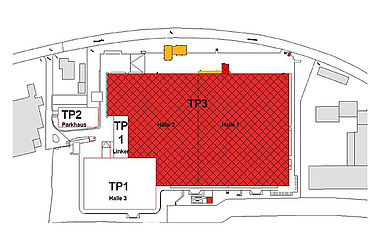

Location Aischweg 7 in Fürth
The construction project "TP3 Fürth Extension Mercedes Benz Logistics Center - Conversion of existing building" comprises the partial demolition of the aggregate warehouse and the diagonally opposite loading ramps with canopy in the northwest of the site.
A new two-storey office extension is planned, which will be connected to the existing hall, as well as two new dock levellers. Eight existing dock levellers will be converted. In addition, a change of use will be made to extend the hazardous materials warehouse in Hall 1. One- and two-storey office space will be installed in the existing halls.
The project is aiming for DGNB "Sustainable Building Site" certification from the German Sustainable Building Council.
-
Characteristics
- Plot area (GF): 116,000 m²
- Area of sub-project 1 (TP1): 10,300 m²
- Area of sub-project 2 (TP2): 9,000 m²
- Area of sub-project 3 (TP3): Total: 54,730 m²
Hall 1 30,200 m²
Hall 2 24,530 m² - Underground: no basement
-
Construction time
- Construction site facilities from 07.05.2024 to 30.04.2026
- Shell construction work from 29.07.2024 to 09.12.2024
- Building envelope from 09.12.2024 to 23.05.2025
- Expansion from 13.01.2024 to 01.09.2025
- Completion 30.04.2026
-
Construction site regular operation
- Monday to Friday 07:00 to 18:00
- Saturday 07:00 to 18:00
- There is generally no work on Sundays and public holidays.
Certified by the German Sustainable Building Council (DGNB)
Ed. Züblin AG is pursuing several goals with this project: A sustainable construction site organization, the conservation of resources as well as the minimization of emissions, responsibility for the health and well-being of the builders, the cultivation of good neighbourliness and, of course, high-quality construction. For this, Ed. Züblin AG was the first company to be recognized by the German Sustainable Building Council (DGNB).
Here you can find more information about the DGNB system for sustainable construction sites: https://www.dgnb.de/en/certification/buildings/construction-site
Selected measures in the project
-
Finished parts
The extensive use of prefabricated parts (filigree slabs, cavity walls, parapets, columns, beams and stairs) means that a shorter construction time can be achieved. The volume of waste is also reduced thanks to the prefabricated orders.
-
Digital concrete call-off
In order to be able to coordinate the concreting in the best possible way, the call-offs are made using a digital application. The delivery rates can be coordinated with the concrete pump, particularly for large-scale concreting, thus reducing the waiting times of the concrete mixers. Production times are optimized and noise emissions are reduced.
-
Saving resources and reducing emissions through LEAN Construction
As part of the lean approach, a production plan with call-off dates (e.g. insulation) was created. Construction production planning is detailed on a weekly basis and adapted to actual production progress. Changes in the construction process are constantly taken into account and just-in-time deliveries can be better implemented. Repeat orders and new orders due to late changes to the plan are avoided.
-
Measures to prevent pollution from the construction site
The project is located in the city center, so the impact of the construction site will be avoided or reduced as much as possible.
-
Energy management in construction
Construction site investigations and comparative considerations for the most energy-efficient project execution possible. For example, selection of a large concrete bucket to reduce the number of lifts.
| Certification contact person | Valerie Sartorius |
| Project contact | Gerhard Obermayr |
| Construction site address | Aischweg 7 90768 Fürth Phone +49 911 6886-361 ZÜBLIN Bavaria Subdivision Secretariat Nuremberg unit |
| Download | Press release |
| Link | DGNB: Certification |
