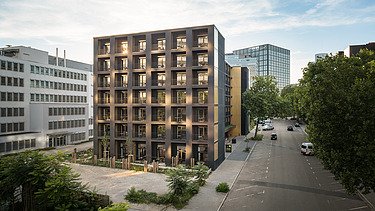

Aparthotel Eschborn
Location:
Eschborn
Build time:
8/2022 - 8/2024
Client:
P+B Group
Aparthotel Eschborn
The Campo Novo Business aparthotel in Eschborn was built using a modular construction method with 179 apartments, some of which are barrier-free, and offers particularly efficient implementation thanks to the high degree of prefabrication and the LEAN cycle. The sustainable building technology with KfW 40 standard, photovoltaics, heat pump and retention roof underlines the project's resource-conserving approach.
The Aparthotel Eschborn continues the long-standing partnership between the Karlsruhe Directorate for Turnkey Construction and the Troisdorf-based P+B Group. This is already the fifth joint project. In addition to the Subdivision Karlsruhe, the SFB division, the Central Directorate was also involved in the construction of the shell of the building. The centrally located aparthotel was built in the Eschborn Süd industrial estate, has ideal transport links and is in the immediate vicinity of the Frankfurt metropolis. With a total living space of 4,387 square meters and 179 rooms, Campo Novo Business offers furnished apartments for individual needs.
The project comprises 179 apartments with 18 barrier-free and 2 fully barrier-free apartments spread over six upper floors and the first floor. The fully accessible apartments offer more space and meet more specific and higher requirements for people who are dependent on a wheelchair, while the first floor houses a modern lobby, reception, a breakfast kitchen and a wash lounge in addition to the apartments. The building also has a partial basement. There is a bicycle room with space for 70 bicycles, which can be accessed directly from the street via a bicycle elevator. The garbage, technical and storage rooms are also located in the basement.
Sustainable construction and technology
The building was constructed to the KfW 40 standard. To achieve this standard, a photovoltaic system and an air-to-water heat pump were installed on the roof. A combined heat and power unit and a gas condensing boiler are used to cover peak loads. The thermal envelope is fully insulated. The following were used on the façade:
- an external thermal insulation composite system (ETICS) with plaster and
- a rear-ventilated façade with Alucobond panels.
The roof was implemented as a retention roof and insulated with pressure-resistant EPS panels and sealed with bitumen. The construction period was 24 months, from August 2022 to August 2024.
Building procedure
The basement was largely constructed using in-situ concrete, the upper floors almost exclusively with semi-precast elements and filigree slabs. All balconies as well as the façade wall panels are fully prefabricated and thermally decoupled from the building. Each balcony is equipped with a powder-coated balcony cabinet to ensure privacy between the apartments. In order to keep the degree of prefabrication as high as possible and to shorten the construction time, prefabricated wet cells and prefabricated shafts were already installed in the shell, which shortened the construction time by a further few weeks and reduced the amount of waste.
Efficient interior fit-out with LEAN
The LEAN principle was used during the interior fit-out, as this allowed the construction project to be planned and implemented more efficiently. The Campo Novo Business aparthotel was ideally suited to LEAN scheduling due to the identical structure of the upper floors, with two LEAN scheduling areas defined per floor, each with 13 and 14 apartments respectively. This structure made it possible for all the finishing trades to work in an orderly, systematic manner with minimal downtime and low resource consumption, enabling the project to be successfully completed after two years of construction. The first guests were able to move in immediately after the building was accepted in August and the Aparthotel Eschborn has enjoyed a high occupancy rate since its opening.
Sustainable construction site "Campo Novo Business"
With this project, Ed. Züblin AG is pursuing several sustainability goals: resource-conserving construction site organization, minimization of emissions, responsibility for the health and well-being of those building, care for good neighborly relations and high-quality construction. The company was the first to be recognized for this by the German Sustainable Building Council (DGNB).
The project is aiming for DGNB "Sustainable Building Site" certification from the German Sustainable Building Council.
-
Characteristics
- Plot area (GF): 1,758 m²
- Gross floor area (GFA): 23,886 m³
- Gross floor area (GFA): 7,619 m²
- Above ground: 7 storeys
- Underground: 1 partial basement
-
Construction time
- Shell construction work from 22.08.2022 to 15.03.2023
- Building envelope from 22.12.2022 to 06.07.2023
- Expansion from 19.01.2023 to 22.09.2023
- Completion 03.11.2023
-
Construction site regular operation
- Monday to Friday 07:00 to 18:00
- Saturday 07:00 to 15:00
- There is generally no work on Sundays and public holidays.
Certified by the German Sustainable Building Council (DGNB)
Ed. Züblin AG is pursuing several goals with this project: A sustainable construction site organisation, the conservation of resources as well as the minimisation of emissions, responsibility for the health and well-being of the builders, the cultivation of good neighbourliness and, of course, high-quality construction. For this, Ed. Züblin AG was the first company to be recognised by the German Sustainable Building Council (DGNB).
Here you can find more information about the DGNB system for sustainable construction sites: https://www.dgnb.de/en/certification/buildings/construction-site
Selected measures in the project
-
Measures to prevent pollution from the construction site
The project is in a central, inner-city location, so efforts are being made to avoid or reduce the impact of the construction site as much as possible. The concepts for noise and dust avoidance and the protection of soil and groundwater on the construction site are key areas of action. There are also concepts for waste avoidance and an environmentally and resident-oriented logistics concept.
-
Saving resources and reducing emissions through LEAN Construction
Through the consistent use of process planning, the ongoing construction work is synchronized and adapted to the planning specifications. This enables stable and structured work. This is accompanied by an increase in quality through efficient processes. This prevents waste.
Another method is the 5S method for order and cleanliness on the construction site. -
Use of (semi-)finished parts
(Semi-)prefabricated elements (cavity walls, filigree slabs and stairs) are used in the project. In addition to shortening the construction time, this also reduces the amount of waste generated by the prefabricated construction elements.
-
Energy management in construction
Preliminary investigations of the individual construction processes with regard to the most energy-saving development possible. In particular, the focus here is on optimizing process durations.
-
Construction site logistics
The just-in-time (JiT) concept ensures targeted and timely coordination of material deliveries to the construction site. The construction products are only transported to the right place at the right time and in the right quantity when they are actually needed. This allows both the number of transports to be reduced and the storage of materials on the construction site to be minimized or completely avoided.
-
Sustainability training
Promoting education and training for all project participants to raise awareness of sustainability.
-
Compliance with environmental protection legislation
Monitoring and compliance with applicable environmental protection laws and regulations.
-
Regional construction partners
Regional companies are involved in the provision of services. This ensures a partnership-based cooperation and synergy effects from existing project knowledge can be utilized.
| Certification contact person | Alexander Houy |
| Project contact | Hans-Jürgen Schmitt, Christoph Federspiel, Hans-Jürgen Egly |
| Construction site address | Alfred-Herrhausen-Allee 2-4 65760 Eschborn Tel. +49721 6204 - 290 ZÜBLIN-Subdivision Karlsruhe Sekretariat Unit SFB |
| Download | Press release |
| Link | DGNB: Certification |
